Implementation Approach

CLOWD9 Implementation - Stages

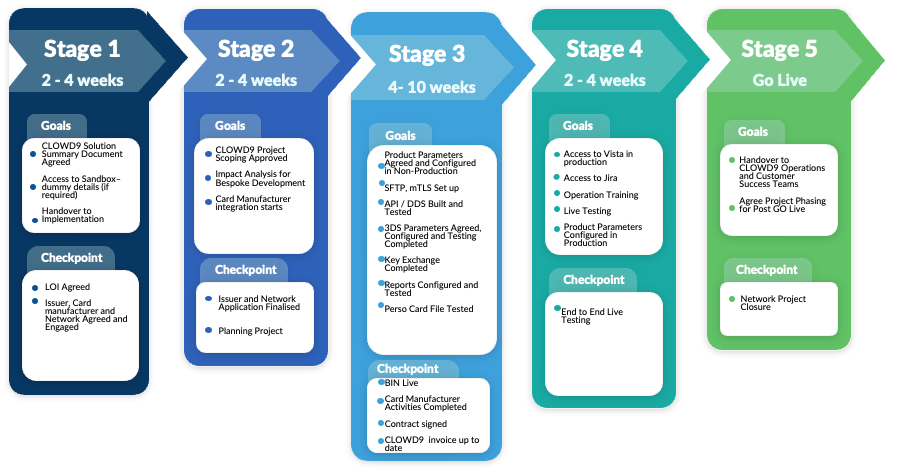

There are 5 key Stages of the project process with checkpoints and deliverables that need to be passed at each stage.


All timeframes are according to readiness to engage, finalise proposition and project scale and engagement with all external parties.

CLOWD9 Implementation - Framework

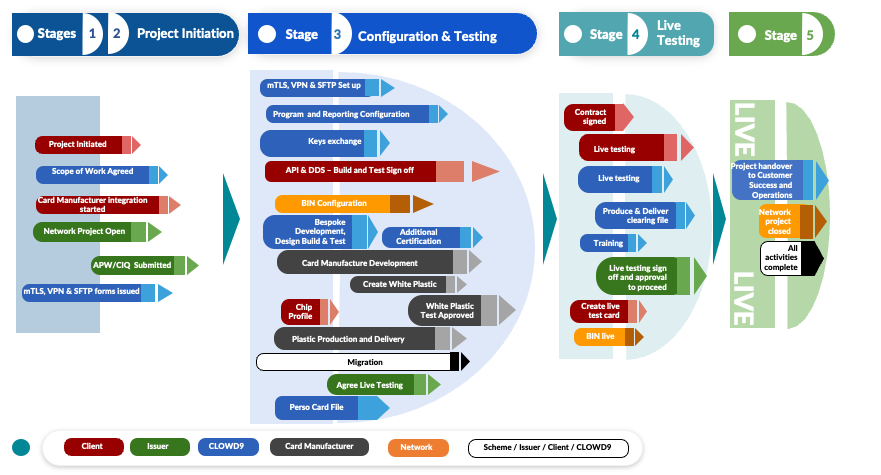

The plan below provides a high level framework of implementation tasks, major milestones, roles and responsibilities that will be completed during each of the stages.


The CLOWD9 Implementation Manager will work on a tailored implementation plan, that provides indicative timelines, taking into consideration additional CLOWD9 development and resources commitments.

CLOWD9 cannot be held accountable for the deliverables of other stakeholders and you will be responsible for managing and maintaining the overall project plan.

ActivityResponsibilityMilestone
Define productProgramme managerAgree stakeholders.
Issuing bank requirements definitionIssuerProgramme requirements signed off.
Scheme project set upSchemeScheme set up and Programme manager assigned.
CLOWD9 programme requirements definitionCLOWD9 Implementation managerStatement of Work signed off.
BIN set upIssuerBIN set up and approved.
CLOWD9 dashboard accessCLOWD9 Implementation managerProgramme parameters defined.
Key exchangeCard Manufacturer/Third party providers/SchemeKey exchange in Test and Production completed.
Card manufacturer developmentCard manufacturerCard embossing file developed.
VPN and SFTP set upCLOWD9 (infrastructure)Connectivity with programme manager, issuer and card manufacturer completed.
3DS set up and test3DS provider/Implementation Manager3DS screen templates/client configuration and test in UAT signed off.
Creation of test cardsProgramme managerProgramme configuration in test completed
Test card file submit to card manufacturerCLOWD9 Implementation managerTest card file validated.
Addition Scheme certification (if required)CLOWD9 technical teamCertification approved.
API build and testClientAPI testing completed and programme configuration signed off.
Programme set up in production environmentCLOWD9 Implementation managerProduction environment readiness.
Define and agree chip profileCard manufacturer/Issuer/Programme managerScheme chip profile approved.
Chip profile testing (if required)Card manufacturer/SchemeChip profile testing completed and signed off.
TrainingCLOWD9 Implementation managerTraining completed and access to production environment granted
Create limited number of cards in productionProgramme managerCard embossing file submitted to card manufacturer.
Pavement testingCLOWD9 Implementation manager /Programme manager/Issuer/CLOWD9Pavement testing completed.
Migration (if applicable)CLOWD9 Implementation managerMigration completed.
HandoverCLOWD9 Implementation managerHandover completed.
